Las Virgenes - Calleguas Interconnection Project

The Las Virgenes portion of the project has been completed.

For information on the current status of the Calleguas portion of the project, please visit http://www.cmwd-lvmwdinterconnection.com/

Description

Las Virgenes Municipal Water District and Calleguas Municipal Water District own and operate potable water systems largely dependent on imported water supply. Both agencies are subject to scheduled and unscheduled interruptions of water deliveries that can negatively impact their ability to deliver potable water to their respective customers. On March 10, 2015, LVMWD and CMWD entered into an interconnection agreement in order to improve future reliability of both systems. This interconnection is a cost-effective way to deliver water between agencies if one were to experience a complete or partial supply interruption that did not significantly affect the other agency and would be of mutual benefit to both systems. Additionally, the interconnection would facilitate LVMWD’s filling of the Las Virgenes Reservoir during the winter months. The project would also enable LVMWD to expand recycled water service within its service area through construction of new pipeline laterals and service connections.

LVMWD is responsible for the construction of the South pipeline segment connecting LVMWD’s system (at the Thousand Oaks Boulevard and Lindero Canyon Road intersection) and the proposed Pump Station/Pressure Reducing Station (PS/PRS) site. The proposed South interconnection pipeline will be installed under the southbound lanes of Lindero Canyon Road within the City of Westlake Village, southward from the PS/PRS site to Thousand Oaks Boulevard. The South interconnection pipeline is composed of 4,977 linear feet of 30-inch welded steel pipe.

Project Map

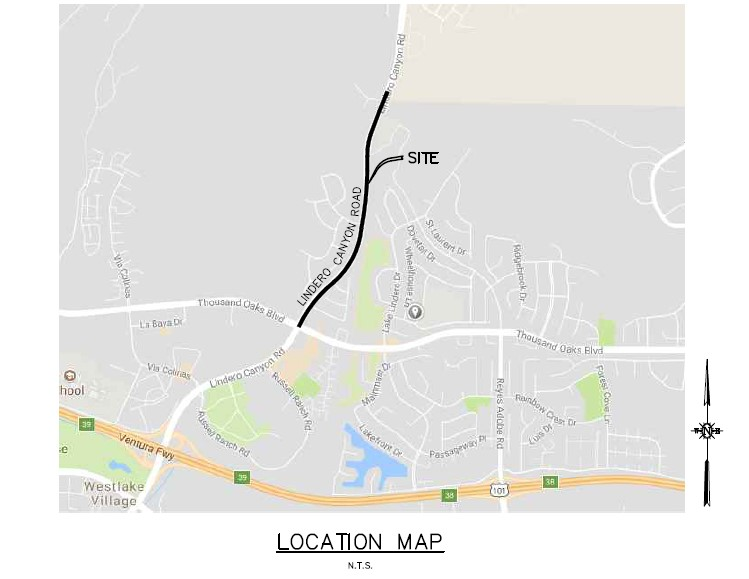

This map shows the location of the interconnection project, north of Thousand Oaks Boulevard and south of Kanan Road on Lindero Canyon Road.

Map showing Lindero Canyon Road and a site location near Thousand Oaks Blvd in Westlake Village.

Schedule Updates

This section will list recently completed and upcoming construction activities and will be updated  weekly once construction begins.

 Recently Completed:

  • All the fiber conduit has been installed.
  • All 5,000 LF of the 30 inch water main have been installed.
  • All 1,882 LF of the recycled waterline has been installed.

Upcoming Field Work:

Week of 7/6/21: Installation of air-vacuums, blow offs, and other appurtenances along the pipeline alignment. Filing of the pipelines for disinfection and testing. Cathodic protection testing

Week of 7/12/21: Connection of new waterline to the main system. This includes overnight work at the intersection of Lindero Canyon Rd and Thousand Oaks Blvd.

Week of 7/19/21: Grind and paving of Lindero Canyon Rd from Thousand Oaks Blvd north one-mile

Public Outreach

At LVMWD, we are committed to maintaining a high level of communication and transparency with our local community. We will regularly update this dedicated webpage to keep you informed of the project. We will also be utilizing mailers, door hangers, social media, and our Everbridge alert system to keep residents informed of construction impacts. We have been working closely with the cities of Westlake Village and Thousand Oaks to finalize traffic control plans, construction sequencing, and specified work hours, all to minimize the impacts to local residents.

Letter to Residents and Businesses Regarding Interconnection Project

Environmental Documentation

The Interconnection Agreement between LVMWD and CMWD specifies that CMWD will be the lead agency under CEQA. The final Environmental Impact Report (FEIR) for this project was completed by CMWD. As responsible agency, LVMWD has filed notices of determination for the project in both counties. A copy of the Final Environmental Impact Report can be found here:

Construction

LVMWD issued a call for bids on July 9, 2020. The Call for bids included optional work for the City of Westlake Village (City). The City work includes installation of new fiber optics conduit and full street repaving along Lindero Canyon Road.

As part of this project, LVMWD will also retain the services of a professional consultant to perform inspection and construction management services during construction, as well as a firm to provide cultural resources training and monitoring in compliance with mitigation measures identified in the Environmental Impact Report.

Construction Schedule:

The construction schedule for this project is presented below. This schedule outlines general milestones for the project, and is subject to change as dates approach. As LVMWD nears groundbreaking activities, schedule updates will be provided on this page.

Construction Contract AwardedSeptember 2020
PotholingNovember 2020
Begin Construction of 30” PipelineJanuary/February 2021
Begin Construction of Recycled Water LinesFebruary/March 2021
Repaving of Lindero Canyon RoadApril/May 2021
Tentative Completion of Major Construction ActivitiesMay 2021

Contact

For questions related to this project, the LVMWD project manager is:

Project Completion Tracker

A horizontal bar chart showing construction progress, with about 30% complete in blue and 70% remaining in orange.

Project Photos

Pending

Important Notes

  • This project is funded by an Proposition 84 IRWM Grant and LVMWD wishes to thank the Los Angeles County Public Works and Department of Water Resources for their support
  • This website is intended to convey information about the south pipeline connection to the PR/PRS station.  Information specific to the construction of the PR/PRS station itself and CMWD’s northern pipeline construction may not be reflected on this site and questions should be directed to Calleguas Municipal Water District.

Sign up for eNotification to receive information and updates on this project by filling out the short form below.

There was a problem saving your submission. Please try again later.
Please wait while your submission is being saved...
Thank you, your submission has been received.
